What to Expect During Septic System Installation

Septic system installation costs $3,000-$25,000+ depending on system type and soil conditions. Learn the complete process, timeline, and cost breakdown.

🛡️Reviewed by Editorial Team📅Updated 2026-02-24⏱️26 min read
✍️By Mark, Founder & Editor

Quick Answer

Septic system installation costs between $3,000 and $9,500 for conventional systems, while advanced systems like aerobic or mound designs run $10,000 to $25,000+. Installation takes 3-7 days for the physical work, but the entire process from permits to completion typically spans 6-12 weeks.

How Much Does It Cost to Have Septic System Installed?

You've just purchased your dream property, but there's one problem: no sewer connection. Or maybe your 30-year-old septic system has finally given up. Either way, you're facing a major project that'll involve heavy equipment tearing up your yard and a price tag that makes you nervous.

Installing a new septic system isn't cheap, but understanding what you're paying for makes the process less intimidating. Let's break down exactly what to expect during installation—from the first soil test to the final inspection.

How Much Does Septic System Installation Cost?

Most homeowners pay between $3,000 and $9,500 to install a conventional gravity-fed septic system. That's the national average for a standard 3-4 bedroom home with favorable soil conditions.

💡 Key Takeaway: Your actual cost depends heavily on your specific situation. Alternative systems required by challenging soil conditions or local regulations can push costs significantly higher—sometimes reaching $25,000+.

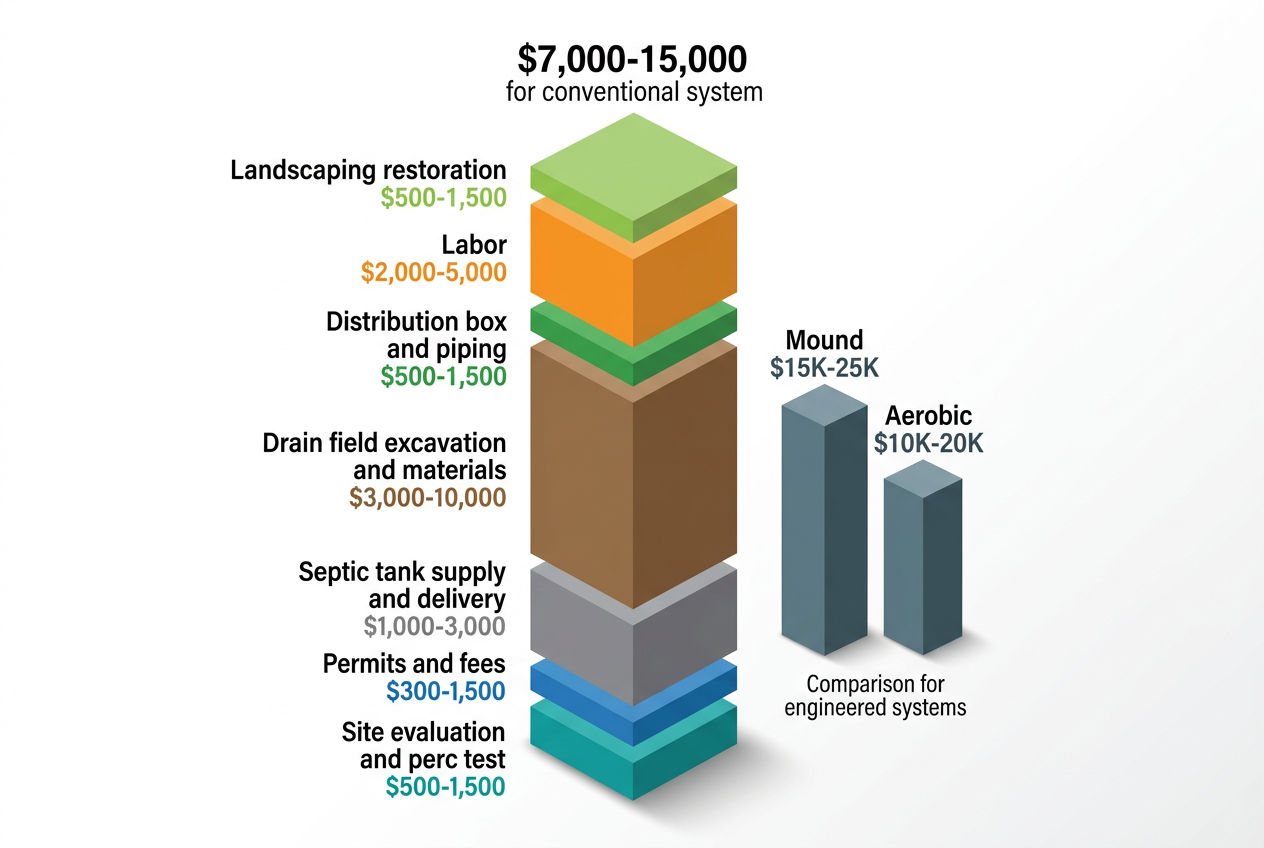

Complete Septic Installation Cost Breakdown

Here's where your money actually goes:

Component Cost Range Notes
Percolation Test $750 - $1,500 Required before permit application
System Design & Engineering $500 - $2,500 Higher for complex sites
Permits & Inspections $200 - $2,000 Varies significantly by county
Septic Tank (materials) $600 - $2,000 Concrete tanks cost more than plastic
Drain Field Materials $2,000 - $5,000 Includes pipes, gravel, fabric
Excavation & Labor $1,500 - $4,000 Depends on soil type and access
Total (Conventional) $3,000 - $9,500 Standard gravity system
Total (Advanced Systems) $10,000 - $25,000+ Aerobic, mound, or engineered systems

Cost by System Type

Not all septic systems cost the same. Your soil conditions and property characteristics determine which type you'll need:

Conventional Gravity System: $3,000 - $9,500 The most affordable option. Works when you have good soil drainage and adequate space. Wastewater flows naturally from your house to the tank to the drain field using gravity alone.

Pressure Distribution System: $7,000 - $12,000 Required when your drain field sits uphill from the tank or soil absorption is marginal. Uses a pump to evenly distribute wastewater throughout the drain field.

Aerobic Treatment System: $10,000 - $18,000 Injects oxygen into the treatment process, producing cleaner effluent. Required in some environmentally sensitive areas or properties with poor soil drainage. Needs electricity and more frequent maintenance than conventional systems.

Mound System: $15,000 - $25,000 Built above ground when soil is too shallow or dense for standard drain fields. Requires importing sand and fill material, plus additional engineering. Common in areas with high water tables or bedrock close to the surface.

Chamber System: $5,000 - $12,000 Uses gravel-less plastic chambers instead of traditional stone trenches. Easier to install in tight spaces and reduces material costs, but chambers themselves cost more than gravel.

📊 Quick Fact: For a detailed comparison of all system types and their costs, check out our complete septic installation cost breakdown.

What Affects Your Installation Cost?

Property Size and Household Capacity

Your tank size depends on your home's bedroom count, not square footage. A 3-bedroom home typically requires a 1,000-gallon tank, while a 5-bedroom home needs 1,500 gallons minimum. Larger tanks mean higher material and installation costs.

Soil Conditions

This is the biggest variable. Sandy soil drains beautifully and keeps costs down. Clay soil barely absorbs water and might require a more expensive alternative system. Rocky soil increases excavation costs—sometimes by 50% or more when you're blasting through ledge.

Site Accessibility

Can excavators easily reach your installation area? Or do they need to navigate through tight spaces, remove trees, or work on steep slopes? Difficult access adds $1,000 to $3,000 to your project.

Local Regulations

Some counties require advanced treatment systems regardless of soil conditions. Others mandate engineering certifications for all designs. Coastal areas often have stricter environmental requirements. Your local septic regulations directly impact your final cost.

Distance from House to Drain Field

The farther wastewater travels, the more pipe and excavation you're paying for. Every additional 50 feet typically adds $500 to $1,000.

Septic System Installation Steps & Process

Understanding how septic installation actually works helps you know what contractors are doing—and whether they're doing it right. Here's the complete process from start to finish.

Step 1: Percolation Test (Perc Test)

Before anyone breaks ground, your soil gets tested. A licensed soil scientist or engineer digs test holes across your proposed drain field area—usually 6-12 holes about 2-3 feet deep.

They fill these holes with water and measure how quickly it drains. This percolation rate determines whether your soil can handle a conventional system or if you'll need alternatives.

Timeline: 1 day for the test, plus 1-2 weeks for the official report
Cost: $750 - $1,500

📊 Quick Fact: Your perc test reveals absorption rates measured in minutes per inch (MPI). Ideal soil drains at 5-30 MPI. Faster than 5 MPI means water moves too quickly for proper treatment. Slower than 60 MPI and you're looking at alternative systems.

Step 2: System Design and Engineering

Once you know your soil characteristics, an engineer designs a system specifically for your property. This isn't generic—it accounts for your household size, soil type, setback requirements, and local codes.

The design shows:

  • Exact tank placement location
  • Required drain field size and configuration
  • System type that meets regulations
  • Professional engineer's stamp (required by many counties)

Timeline: 1-3 weeks
Cost: $500 - $2,500 (higher for complex sites requiring advanced engineering)

Step 3: Permit Application and Approval

Your installer submits the engineered design, perc test results, site survey, and application to your county health department. They review everything to confirm the system meets local codes.

This is where projects often stall. Some counties approve permits in 2 weeks. Others take 6-8 weeks, especially during busy spring and summer seasons.

Timeline: 2-8 weeks (varies significantly by county)
Cost: $200 - $2,000 (permit fees vary by location and system complexity)

✅ Pro Tip: Apply for permits in winter when health departments are less busy. You'll get faster approvals even if you're not installing until spring.

Step 4: Site Preparation and Excavation

Once permits are approved, the real work begins. Heavy equipment arrives to dig the tank hole and excavate trenches for the drain field.

Excavators dig your tank hole deep enough to maintain proper slope from your house (typically 1/4 inch drop per foot of pipe). The drain field gets excavated to specific depths—usually 18-36 inches below grade, depending on your design.

Good contractors are precise here. Drain field trenches need level bottoms for even wastewater distribution. Too much slope and effluent pools at the low end. Not enough and it won't distribute properly.

Timeline: 1-2 days
What to expect: Loud machinery, torn-up yard, large dirt piles

Step 5: Tank Installation

Your septic tank arrives on a flatbed truck—concrete tanks weigh 8,000+ pounds. A crane or large excavator carefully lowers it into the prepared hole.

Critical installation details:

  • Tank sits on 6-inch gravel bed for stability and drainage
  • Precise leveling required—even slight tilting affects solids settlement
  • Inlet pipe (from house) positioned higher than outlet pipe (to drain field)
  • Proper flow direction ensures wastewater moves correctly

Concrete tanks are most common and last 40+ years. Plastic tanks cost less but some counties don't approve them. Fiberglass tanks resist corrosion but crack more easily during installation.

Timeline: Half day

Tank Sizing Guide:

  • 2 bedrooms: 750-900 gallons
  • 3 bedrooms: 1,000 gallons
  • 4 bedrooms: 1,200-1,250 gallons
  • 5 bedrooms: 1,500 gallons

Step 6: Drain Field Construction

The drain field (also called leach field) is where wastewater actually gets treated. Effluent from your tank flows into perforated pipes surrounded by gravel, then slowly seeps into the soil. Beneficial bacteria in the soil treat it as it percolates down.

For conventional systems, installers lay perforated distribution pipes in gravel-filled trenches. Each trench is typically 18-36 inches wide and runs 50-100 feet long. The gravel provides space for water to flow and oxygen for bacterial treatment.

A fabric layer goes over the gravel before backfilling to prevent soil from clogging the system. Some newer designs use gravel-less chambers—arched plastic tunnels that create void space without stone.

Timeline: 1-2 days

Typical Drain Field Specifications:

  • Trench depth: 18-36 inches
  • Trench width: 18-36 inches
  • Total length needed: 200-600 feet (depends on soil absorption rate)
  • Gravel depth: 12-18 inches minimum
  • Minimum area: 300-600 square feet

📊 Quick Fact: For more details on drain field construction and future replacement costs, see our drain field replacement cost guide.

Step 7: Plumbing Connections

Installers connect your house's main sewer line to the tank inlet. This requires proper slope—typically 1/4 inch per foot—so wastewater flows without pumping.

Key connection components:

  • Outlet pipe connects tank to drain field
  • Distribution box splits flow evenly between multiple trenches
  • All joints sealed to prevent leaks and groundwater infiltration
  • Risers added to bring access ports closer to ground level for future pumping

Timeline: Half day

Step 8: Inspections

County inspectors visit at multiple stages to verify proper installation. Most require at least two inspections:

Tank Inspection: Before backfilling, inspectors verify tank size, placement, and connections. They check inlet/outlet elevations and make sure everything meets approved plans.

Final Inspection: After backfilling but before covering the drain field, inspectors verify proper construction. They confirm drain field dimensions, materials, and proper grading.

⚠️ Warning: You can't use your system until it passes final inspection. If something's wrong, contractors must fix it and schedule re-inspection.

Timeline: Coordinate with contractor; inspectors usually come within 2-5 business days of request

Step 9: Backfilling and Restoration

After passing inspection, contractors backfill everything. Soil goes back over the tank, pipes, and drain field. They grade the surface to prevent water from pooling.

Don't expect your yard to look perfect immediately. The disturbed area will settle over time. Most contractors seed or sod the area, but it takes a season to fully blend with surrounding landscape.

⚠️ Warning: Never drive over or plant trees on your drain field. Keep the area accessible for future maintenance and avoid soil compaction that interferes with treatment.

Timeline: 1 day

How Long Does Septic Installation Take?

The physical installation work takes 3-7 days for conventional systems. Complex systems like mounds or aerobic treatment units might take 1-2 weeks.

But that's not the full story. The complete timeline from initial perc test to final approval runs 6-12 weeks on average:

Phase Duration
Perc test and report 1-2 weeks
System design and engineering 1-3 weeks
Permit approval 2-8 weeks
Physical installation 3-7 days
Inspections and final approval 1 week
Total typical timeline 6-12 weeks

What Can Delay Your Installation?

Permit Backlogs

This is the most common delay. Some counties process permits in 2 weeks. Others take 2 months, especially during busy construction seasons. Apply early—ideally in winter for spring installation.

Weather Conditions

Heavy rain makes excavation impossible. Installers can't work in saturated soil because heavy equipment causes compaction that ruins drain field performance. Frozen ground in northern states completely stops work from December through March.

Failed Inspections

If your tank placement is off or drain field construction doesn't match plans, you'll fail inspection. Contractors must correct issues and reschedule, adding 1-2 weeks.

Equipment Breakdowns

Large excavators occasionally break down mid-project. While professional contractors have backup plans, mechanical issues can add several days.

Underground Surprises

Sometimes excavators hit unexpected ledge, boulders, or high groundwater. These conditions require design modifications and potentially new permits, adding weeks to your timeline.

Best Time of Year to Install

Late spring through early fall offers the best conditions in most regions. The ground has dried from winter moisture but hasn't frozen yet. Contractors are busy during this window, so book early.

Summer advantages:

  • Driest soil conditions
  • Fastest excavation
  • Quickest settling and compaction
  • Easier scheduling of inspections

Fall considerations:

  • Still good conditions in most regions
  • Contractors less busy (potential cost savings)
  • Must finish before ground freezes in northern states

Winter challenges:

  • Frozen ground in northern states makes excavation difficult or impossible
  • Some contractors add 15-30% winter surcharge
  • Extended timelines due to weather delays
  • Can't do perc tests when ground is frozen

Spring issues:

  • High water tables from snowmelt and rain
  • Muddy conditions delay work
  • Perc tests may show false slow absorption rates
  • Permit processing backlogs as construction season starts

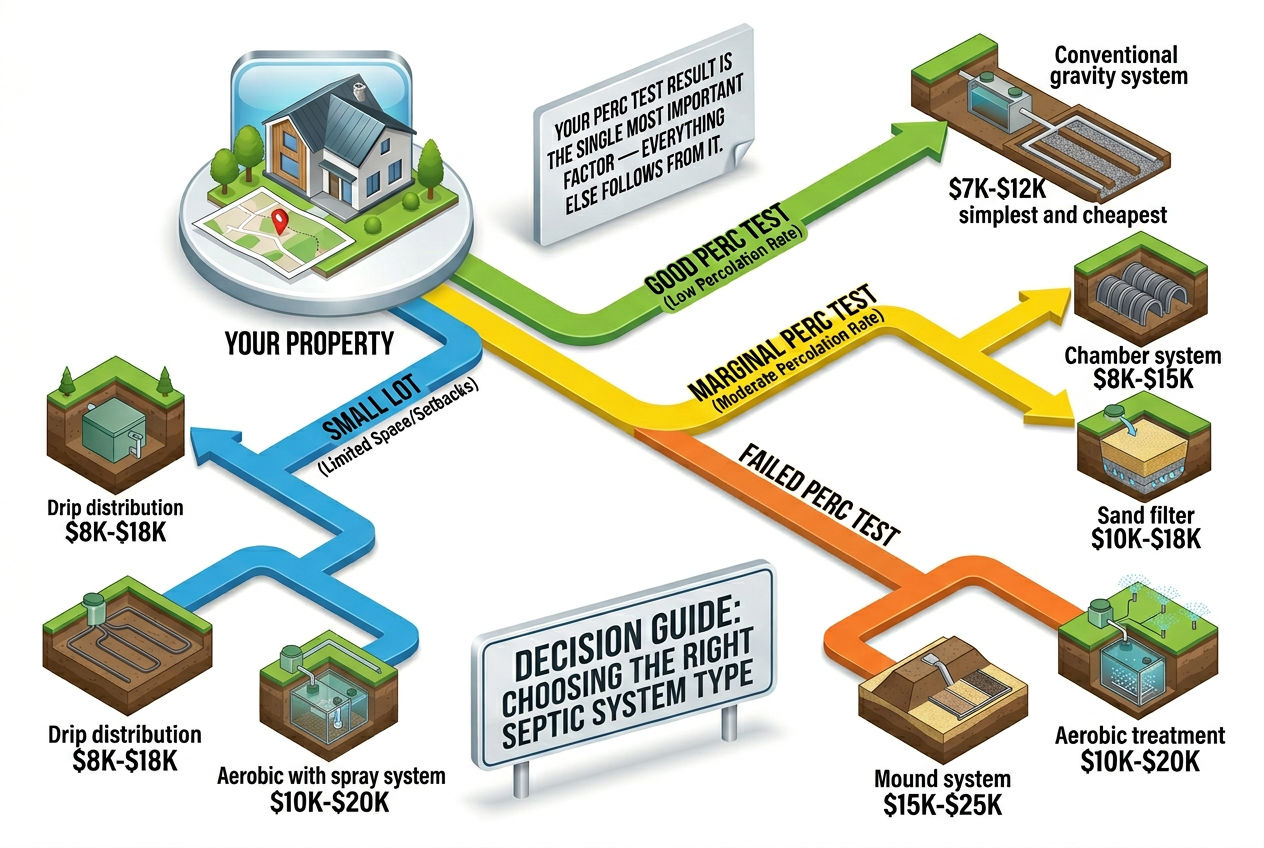

Choosing the Right System for Your Property

Your soil type and property characteristics determine which system works best. You usually don't get to just pick your favorite—local codes and site conditions make the decision for you.

Conventional Gravity System: The Default Choice

If your perc test shows good absorption rates (5-60 minutes per inch) and you have adequate space, conventional systems are the obvious choice. They're the most affordable, require no electricity, and need minimal maintenance beyond regular pumping every 3-5 years.

Best for:

  • Properties with well-draining soil (sandy or sandy loam)
  • Adequate lot size for proper setbacks
  • Tank location downhill from house, uphill from drain field
  • Homeowners wanting lowest long-term costs

When You'll Need Alternative Systems

Sometimes conventional systems simply won't work. Alternative systems cost more upfront but they're your only option when:

High Water Table

When groundwater sits close to the surface, mound systems raise the drain field above grade. The imported sand fill provides treatment before effluent reaches groundwater. Mound systems are common in low-lying areas, near lakes, or regions with shallow bedrock.

Poor Soil Drainage

Clay-heavy soil drains too slowly for conventional systems. Aerobic treatment units pre-treat wastewater more effectively, so it doesn't need as much soil contact time. Some systems use pressurized distribution to force effluent into the soil more effectively.

Small or Irregular Lots

When you don't have room for a standard drain field, chamber systems or specialized designs fit into tighter spaces. Some alternative systems reduce the drain field size by 30-50% compared to conventional designs.

Environmental Regulations

Properties near water bodies, in coastal zones, or in environmentally sensitive areas often require advanced treatment systems regardless of soil quality. These systems produce cleaner effluent that meets stricter discharge standards.

Getting Multiple Quotes

Installation costs vary significantly between contractors. Get at least three written quotes that specify:

  • Complete system design (tank size, drain field dimensions, system type)
  • All permits and fees included
  • Timeline from start to finish
  • Warranty terms
  • What happens if they hit bedrock or other obstacles

✅ Pro Tip: The lowest bid isn't always best. Experienced installers know local regulations, get permits approved faster, and build systems that pass inspection the first time. A contractor who's installed 500 systems in your county is worth more than one charging $1,000 less but learning as they go.

Find qualified septic installation contractors in your area to get competitive quotes specific to your property.

Regional Cost and Regulation Variations

Where you live dramatically affects installation costs and requirements. A system that costs $5,000 in rural Texas might run $15,000 in coastal Massachusetts.

Northeast: Highest Costs, Strictest Regulations

Expect to pay $5,000 - $15,000+ for basic installations, with complex sites reaching $25,000.

Why costs run high:

  • Frost depth requirements mean digging 4-6 feet down
  • Rocky soil and ledge require expensive blasting
  • Shorter construction season (typically May-October)
  • Stricter environmental regulations
  • Higher labor costs overall

New York and Massachusetts have particularly stringent requirements. Many towns require Title 5 inspections (Massachusetts) or county-specific engineered designs. Coastal areas mandate advanced nitrogen-reducing systems.

💡 Key Takeaway: If you're in the Northeast, budget at the higher end and expect extended permit timelines—8-16 weeks isn't unusual.

Southeast: Year-Round Installation, Water Table Challenges

Installation costs run $3,500 - $12,000 depending on specific site conditions.

Regional considerations:

  • High water tables require mound systems in many areas
  • Sandy soil drains quickly but provides less treatment
  • Hurricane and flood zone regulations add requirements
  • Year-round construction possible
  • Lower labor costs than northern states

Florida properties frequently need aerobic systems or performance-based treatment units. The high water table and environmental sensitivity around lakes and coastal areas demand advanced treatment. For example, septic services in Orlando often involve mound or aerobic systems due to the region's geology.

Midwest: Seasonal Work Windows, Clay Soil

Typical costs: $3,000 - $9,000 for conventional systems.

Key factors:

  • Clay-heavy soil often requires pressure distribution systems
  • Installation limited to April-October in northern areas
  • Relatively straightforward permitting process
  • Adequate lot sizes in rural areas keep costs down

Wisconsin, Michigan, and Minnesota installers can't work during frozen months. Plan for spring installation but apply for permits in winter.

Southwest: Rock and Caliche Challenges

Budget $3,500 - $10,000 for most installations.

What drives costs:

  • Rocky soil increases excavation difficulty
  • Caliche (hardened calcium carbonate layer) requires special equipment
  • Limited soil depth in some areas
  • Water conservation requirements in drought-prone regions

Texas properties often hit caliche at 2-3 feet down—a cement-hard layer that requires breaking through with specialized equipment. This can add $2,000-$4,000 to excavation costs. Professional septic contractors in Dallas typically have the heavy-duty equipment needed for these conditions.

Pacific Northwest: Advanced Treatment Requirements

Expect the highest costs outside the Northeast: $8,000 - $20,000+

Why systems cost more:

  • High rainfall requires robust drain field design
  • Advanced treatment systems often mandated
  • Strict environmental protections around water bodies
  • Challenging terrain and limited flat areas
  • Seasonal installation windows due to wet conditions

Washington and Oregon have some of the country's strictest septic regulations. Many areas require sand filters, aerobic treatment, or other advanced technologies beyond basic septic systems.

After Installation: What Happens Next

Your new septic system is in the ground and passed final inspection. Now what?

Initial Break-In Period

Bacterial colonies need time to establish in your tank and drain field. These beneficial microorganisms do the actual work of breaking down waste.

For the first 30 days:

  • Run only full loads of laundry (spread throughout the week)
  • Avoid garbage disposal use
  • Don't use excessive household cleaners
  • Limit water softener regeneration if possible

⚠️ Warning: Heavy water use during this initial period can overwhelm the system before bacterial populations establish. Spread out water-intensive activities.

Routine Maintenance Starts Now

Your septic system needs regular attention to reach its 20-40 year lifespan. The biggest maintenance task is pumping—removing accumulated solids from your tank.

Pumping Schedule:

  • 1-2 person household: Every 5-7 years
  • 3-4 person household: Every 3-5 years
  • 5+ person household: Every 2-3 years
  • Garbage disposal users: 50% more frequent pumping

These intervals assume normal use. Heavy water use, garbage disposal, or commercial activities require more frequent pumping. Learn more about professional septic pumping and maintenance to keep your system functioning properly.

Protect Your Drain Field

Your drain field is the most expensive component to replace—$3,000-$15,000 if it fails. Protect it by:

  • Never driving or parking vehicles over the drain field
  • Avoiding deep-rooted trees and shrubs (roots clog pipes)
  • Keeping the area grass-covered (prevents erosion)
  • Directing roof and surface water runoff away from the area
  • Never building structures over the drain field

⚠️ Warning: Soil compaction from vehicles crushes the void spaces that allow effluent to flow and oxygen to reach treatment bacteria. A single instance of driving a loaded truck over your drain field can cause permanent damage.

Watch for Warning Signs

Between routine maintenance, monitor your system's performance. Call professionals if you notice:

  • Sewage odors inside or outside
  • Slow drains throughout the house
  • Gurgling sounds in plumbing
  • Unusually green, lush grass over drain field
  • Standing water or soggy soil over drain field
  • Sewage backing up into house

These symptoms indicate either a full tank needing pumping or more serious problems requiring professional septic inspection. Don't ignore warning signs—small issues become expensive failures if left unaddressed.

Understanding System Longevity

Well-maintained septic systems last decades:

Component Lifespan
Concrete tank 40+ years
Plastic tank 30-40 years
Drain field 20-30 years (with proper maintenance)
Aerobic system mechanical components 10-15 years
Pumps and alarms 10-20 years

Your drain field typically fails first. When effluent can no longer absorb into the soil properly, you'll need drain field replacement—essentially a partial system reinstallation.

💡 Key Takeaway: Regular pumping and water conservation significantly extend drain field life. Systems that receive proper maintenance routinely exceed 30 years before major components need replacement.

Financing Your Septic Installation

A $10,000+ unexpected expense strains most budgets. Fortunately, several financing options exist for septic installation.

Traditional Financing Options

Home Equity Loans or HELOCs

If you have equity in your property, this typically offers the lowest interest rates. You're borrowing against your home's value, so rates run 6-9% currently. Home equity loans provide a lump sum, while HELOCs work like a credit card you draw from as needed.

Personal Loans

Banks and credit unions offer unsecured personal loans for home improvements. Rates run higher than home equity (8-15%) but you don't risk your property as collateral. Approval is faster—sometimes within days.

Contractor Financing

Many septic installation companies partner with lenders to offer project financing. These "instant approval" programs are convenient but often carry higher interest rates (12-25%). Read terms carefully before signing.

Government Programs and Assistance

USDA Rural Development Loans

If your property qualifies as rural, USDA Section 504 loans provide funds for septic systems at 1% interest. The program targets low-income homeowners who can't obtain credit elsewhere. Maximum loan amounts vary by region.

State and Local Programs

Many states offer low-interest loan or grant programs for septic system installation and upgrades. These programs aim to protect water quality by helping homeowners install compliant systems.

Check with your state's environmental or health department. Programs vary significantly—some states offer grants covering 50% of costs, while others provide low-interest loans.

Property Tax Exemptions

Some jurisdictions exempt new septic systems from property tax assessments for several years. This doesn't help with upfront costs but reduces the long-term financial impact.

Budgeting for the Full Cost

Don't forget expenses beyond the installation contract:

  • Temporary living arrangements if your existing system fails completely
  • Landscape restoration after heavy equipment tears up your yard
  • New landscaping plans that work around your drain field location
  • Driveway or sidewalk repairs if access required crossing them
  • Tree removal if large trees interfere with the installation area

✅ Pro Tip: Add 10-15% to your installation estimate as a contingency for unexpected costs. Underground work always carries the risk of surprises—hitting ledge, encountering higher water tables than expected, or discovering old, unmarked utilities.

Find Trusted Septic Pros Near You

Compare top-rated companies in your area. Get free, no-obligation quotes from verified providers.

Share:

Was this article helpful?

📚
FAQs

Frequently Asked Questions

The complete process takes 6-12 weeks on average, including permitting and approvals. The physical installation work itself typically takes 3-7 days for conventional systems, or 1-2 weeks for complex systems like mounds or aerobic units. Most of the timeline involves waiting for perc test results (1-2 weeks), system design (1-3 weeks), and permit approval (2-8 weeks). Weather delays and inspection scheduling can extend timelines further.
Septic installation follows seven key steps: (1) percolation test to evaluate soil absorption, (2) system design and engineering, (3) permit application and approval, (4) site excavation, (5) tank installation, (6) drain field construction, (7) plumbing connections, and (8) inspections. County inspectors typically visit at least twice—once before backfilling the tank and again for final approval. The system can't be used until it passes final inspection.
Yes, virtually all jurisdictions require permits for septic system installation. You'll need to submit engineered designs, percolation test results, and site surveys to your county health department. Permit costs range from $200 to $2,000 depending on location and system complexity. Permit approval takes 2-8 weeks on average. Installing without proper permits can result in fines, required system removal, and complications when selling your property.
While some rural counties allow homeowner installations, DIY septic installation is rarely practical. You'll need heavy equipment like excavators (costing $300-500/day to rent), must still obtain permits and pass inspections, and need an engineered design meeting local codes. Mistakes during installation can cost thousands to repair and may cause premature system failure. Most homeowners who attempt DIY installation end up hiring contractors to complete the work. The money saved rarely justifies the risk and time investment.
Conventional gravity-fed septic systems are the most affordable option, costing $3,000-$9,500 for typical installations. These systems work when you have well-draining soil, adequate space, and favorable site conditions allowing wastewater to flow naturally by gravity. Alternative systems like aerobic treatment units ($10,000-$18,000) or mound systems ($15,000-$25,000) cost significantly more but may be required if soil conditions are poor, space is limited, or local regulations demand advanced treatment.
A conventional septic system for a 3-bedroom house typically costs $3,000-$9,500 nationally. This includes a 1,000-gallon tank (standard size for 3 bedrooms), drain field construction, permits, and labor. However, costs vary significantly based on soil conditions, system type required, and regional differences. Poor soil drainage requiring alternative systems can push costs to $10,000-$15,000+. Rocky soil, difficult site access, or complex local regulations also increase costs substantially.
Late spring through early fall offers the best installation conditions in most regions. Summer provides the driest soil, fastest excavation, and easiest scheduling. However, contractors are busiest during this period, so book early. Fall remains favorable with less competition for contractor time. Avoid winter in northern states where frozen ground makes excavation difficult or impossible. Spring's high water tables and muddy conditions can delay work and affect perc test results. Apply for permits in winter when health departments are less busy to get spring
💧

Need Septic Service?

Get estimates from licensed, verified companies in your area. No obligation.

Browse Services

⚡ Average response time: under 2 hours

Keep Reading

Related Articles
